Right-Of-Way Accessibility

Some GIS maps and web apps are experiencing issues preventing them from opening. The issue is known and a resolution is being worked on.

A header image for the webpage with text reading "AMERICANS WITH DISABILITIES ACT RIGHT-OF-WAY TRANSITION PROGRAM"

ADA Right-Of-Way Transition Plan

Approved in 2024, the ADA Right-of-Way (ROW) Transition Plan establishes a systematic approach and sets forth priorities for the City of Lawrence to achieve compliance with the Americans with Disabilities Act (ADA) in the public right-of-way over the next 20 years. The implementation of this plan will be carried out through the ADA ROW Transition Program.

Program

The Program will oversee and facilitate the construction of improvements outlined in the Plan, which includes sidewalks, shared-use paths, and curb ramps within the public right-of-way, ensuring accessibility for individuals of all ages and abilities throughout the city.

This program will support the City of Lawrence in complying with accessibility standards as required by federal laws, state statutes, and city regulations. Furthermore, it aligns with the objectives of the Strategic Plan for a Connected City, highlighting our commitment to equity and inclusion within the community.

Sidewalk Repairs within the City of Lawrence that are otherwise be accessible will be managed through the Program. When sidewalk complaints are received, they will be inspected, repaired and funded in coordination with other improvements of the plan.

How the ADA Transition Program Works

Over the next 20 years, the City will systemically assess sidewalk conditions, review pedestrian demand, and identify areas with transportation-disadvantaged populations to determine pedestrian routes of greatest need. This data driven process is utilized to identify the annual list of priority sidewalks to be reconstructed. The list will be made available on the website, and letters sent to the adjacent property owners. Those identified sidewalks will then be inspected by the city and hazards marked where repairs are needed.

Given that property owners are financially responsible for the upkeep of their adjacent sidewalk, the City has committed to cost-partnering with property owners to complete sidewalk repairs necessary to bring sidewalks up to ADA standards. Cost-partnering will offer significant cost and time savings to property owners. To be eligible, property owners will have to use the City Contractor, or they may compete the repair at their own cost.

Typical Timeline –

  1. Prioritized Routes Identified
    • City staff uses a data-driven process to determine which routes should be prioritized for reconstruction.
  2. 1st Letter: Initial Notification
    • Property owners along prioritized route will receive an initial letter.
  3. City Inspection of Sidewalk Corridor
    1. City staff will inspect the sidewalk corridor and mark hazards. A white marking indicates hazards caused by City-owned infrastructure (street trees, utilities, etc.). A pink marking indicates hazards that are the responsibility of the adjacent property owner to repair.
  4. 2nd Letter: Summary and Repair Options
    • Property owners will receive a letter with information about the marked hazards and their options for repair and material choices (if applicable).
  5. Request for Contractor Bids
    • The City releases a request for contractors to submit “bids” for the project. The project scope and scale will be determined by the number of property owners utilizing city-contractors.
  6. 3rd Letter: Contractor Selected
    • With a contractor selected the property owner will receive a letter with their estimated share for the cost of construction and the anticipated project schedule.
  7. Construction
    • The City’s contractor reconstructs or repairs the sidewalk.
  8. 4th Letter: Invoice and Payment
    • Invoices will be sent to property owners with a deadline for payment. Property owners will have 90-days to pay the invoice, then any unpaid amount will be accessed on future property taxes.

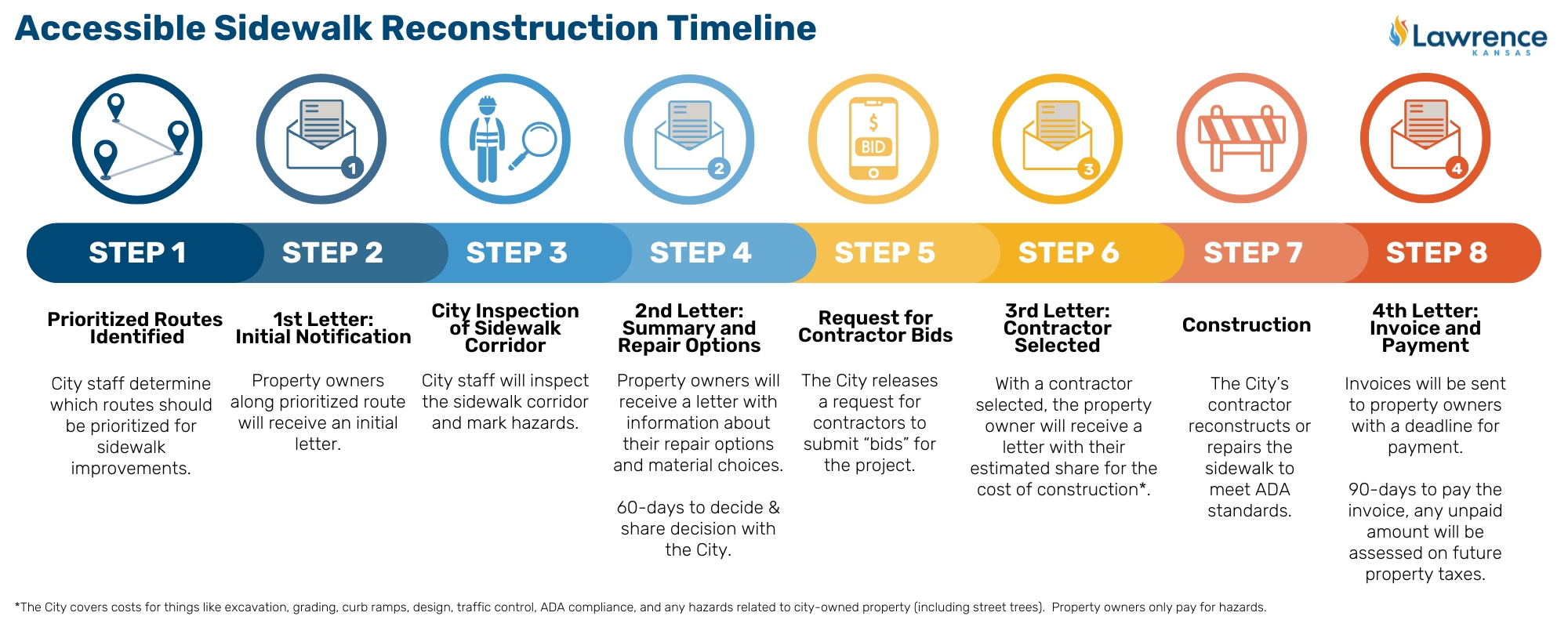

An image of the timeline for sidewalk reconstruction. There are 8 steps in total.
